What are flow metrics?
Flow metrics are a small set of signals — flow velocity, flow time, flow efficiency, flow load, and flow distribution — that show how work moves through your delivery system, from idea to production. They focus on speed, stability, and flow, not just output.
You’re managing eight product teams. Each one ships valuable work. Each one also uses Jira a little differently.
One team closes tickets in hours. Another carries work for weeks. A third has half its sprint sitting in progress. On paper, everything looks busy. Under the hood, flow efficiency is all over the place.
This is where flow metrics start to pay off. They help you spot bottlenecks early, balance capacity across teams, and connect delivery signals to business outcomes like faster releases or more predictable planning.
Instead of piecing together updates from dashboards and standups, flow metrics give you a clearer picture of how work actually moves. And once you see the flow, you can fix it. Explore core flow metrics to understand how work moves and improve it.
The five core flow metrics
The five core flow metrics — velocity, time, efficiency, load, and distribution — come from the Flow Framework. Together, they give you a high-level view of system health: how work moves, where it slows, and whether delivery aligns with your business goals.
Tools like Appfire Flow help you apply these consistently across Jira and Git, so you can spot holdups and act on them at scale. Let's take a closer look at each metric.
1. Flow velocity: How delivery is accelerating
Flow velocity tracks how many work items your teams complete over a set period — a sprint, a month, or a release cycle.
Flow velocity = Completed items ÷ time period in months or number of sprints
Example: If your teams complete 240 work items in a month, your flow velocity is 240 items/month.
It’s one of the most commonly tracked software engineering metrics, and often the first one stakeholders ask about. But raw output alone doesn’t tell the full story. Consistency matters more than spikes.
A team that delivers 40 items every sprint is easier to plan around than one that swings between 20 and 80. Stable agile flow metrics like velocity give you a reliable baseline. That means better forecasting, fewer surprises, and more confidence when you’re committing to timelines.
This is also where expectations get shaped:
- When velocity is steady, you can have clearer conversations with stakeholders: what’s realistic, what’s at risk, and what needs trade-offs.
- When it’s erratic, every plan starts to feel like a guess.
There’s a catch, though.
Velocity is easy to game. Teams can split work into smaller pieces or reclassify items to make numbers look better. Velocity appears to climb, but in reality, nothing improves. That's why your focus should be on system health, including flow efficiency, not just output.
To improve flow velocity in a meaningful way:
- Reduce batch size: Smaller work items move faster and get blocked less often. You’ll see steadier flow across teams.
- Visualize the pipeline: Use clear Kanban boards to show where work is piling up. Hurdles become obvious and harder to ignore.
- Fix visibility gaps across tools: When data lives in silos, you miss the real blockers. Platforms like Appfire Flow help you connect Jira and Git signals, so you can see where work slows down and act on it faster.
2. Flow time: How fast you deliver value
Flow time measures the time your work takes from the moment your team accepts it to the moment it’s live for the customer.
Flow time = completion date − start date
Example: A feature is accepted on March 1 and released on March 11, has a flow time of 10 days.
The clock starts when engineering commits to the work and stops at production. This makes it one of the most actionable DevOps metrics since it reflects what your teams can directly influence.
But don't confuse this with lead time:
- In most Scrum flow discussions, lead time includes everything from idea to delivery, including approvals, backlog wait, and prioritization.
- Flow time is tighter. It focuses on the engineering-controlled portion of the lifecycle. That precision matters when you’re diagnosing delays and improving execution.
When flow time shrinks, time-to-market improves. This means features reach customers faster, feedback loops tighten, and priorities stay relevant. If flow time stretches, value sits idle.
A common example: A security review step adds six days of wait time between “ready” and “deploy.” The work is done, but it's not delivering any value.
To improve flow time:
- Track end-to-end: Measure flow time, cycle time, and throughput together to see where delays build.
- Reduce handoffs: Fewer transitions mean less waiting and less context loss.
- Run flow-based retrospectives: Focus on where time is spent instead of focusing on what was delivered.
3. Flow efficiency: How bottlenecks slow down delivery

Flow efficiency measures how much of your total flow time is spent actively working versus waiting. It’s one of the most useful Scrum team metrics, because it shows where time quietly slips away.
Flow efficiency = (active time ÷ total flow time) × 100

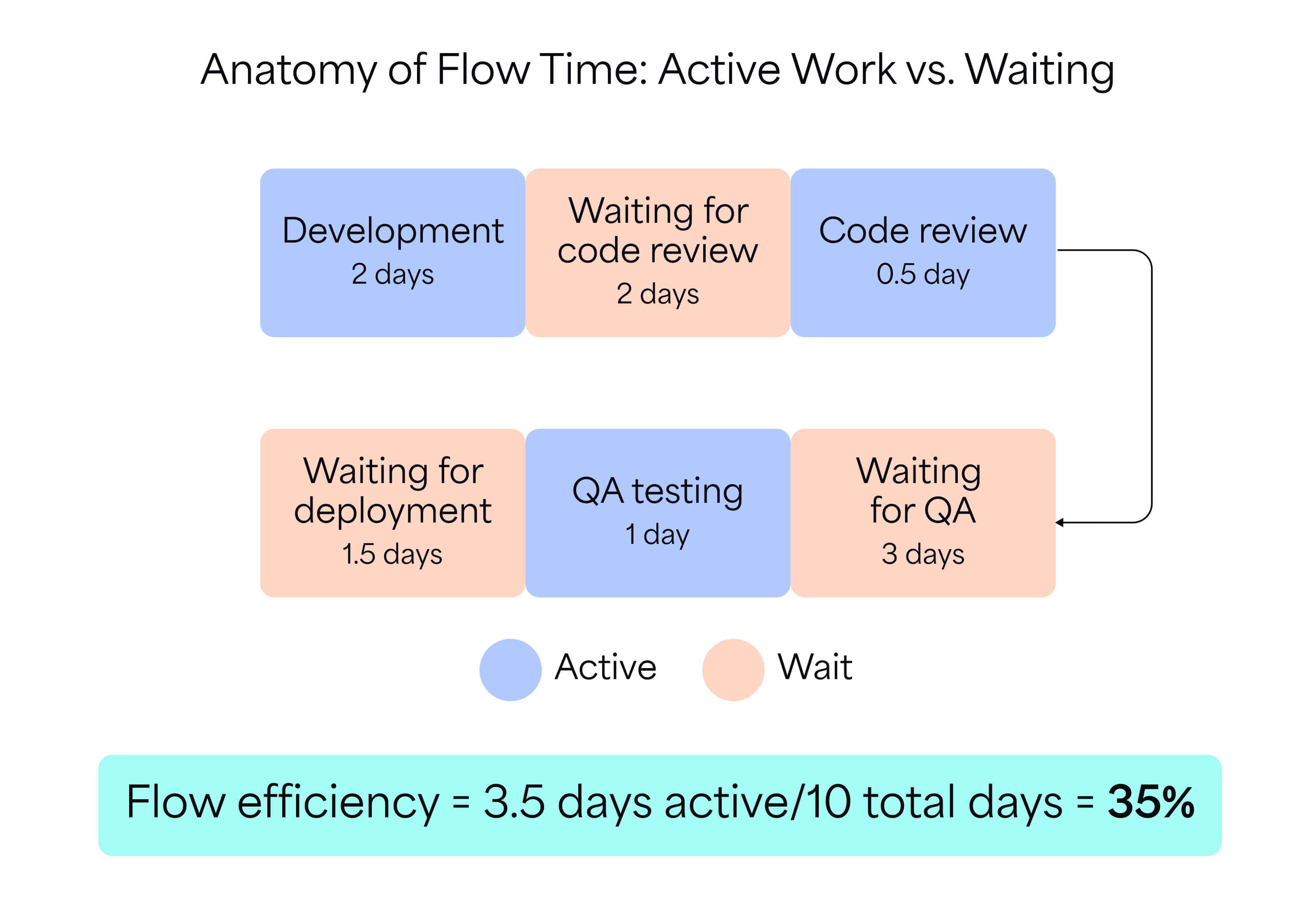

Example: If a task takes 10 days from start to finish, but only two days involve actual work — with the rest spent
waiting on QA, security reviews, or approvals — your efficiency is 20%.
A low score rarely points to developer effort. It points to the system.
Long queues, too many handoffs, and unclear ownership create idle time between steps. Work pauses, context fades, and delivery slows. If you’re using metrics to measure developer productivity, flow efficiency helps shift the conversation away from individual output and toward process health, where the real gains live.
In many DevOps environments, teams often see flow efficiency between 15% and 25%. High-performing systems push beyond that by reducing wait states instead of asking engineers to work faster. Low efficiency is a signal of structural queueing and doesn't indicate a motivation problem.
To improve flow efficiency:
- Reduce queue length: Limit work in progress so items don’t sit idle.
- Identify blockers: Look for stages where work consistently waits (reviews, approvals, testing).
- Improve collaboration: Bring teams closer to reduce handoffs and speed up decisions.
4. Flow load: The number of work items in progress
Flow load measures how many work items are in progress across your value stream at any given time. In simple terms, it’s your total work in progress (WIP).
Flow load = count of active items in the system
Example: If you have 95 items in progress, across 8 teams, your flow load is 95.
As one of the core engineering KPIs, it helps you see how stretched your system really is, not just within a team, but across multiple teams working in parallel.
When the flow load climbs, context switching follows.
Engineers juggle more tasks, priorities shift mid-stream, and focus gets fragmented. And the result is predictable: longer delivery times, more defects, and rising fatigue across teams.
In multi-team setups, high flow load doesn’t just slow work down. It compounds across dependencies, creating delays that ripple through the system.
This is also where roadmap protection comes into play. When you can point to rising flow load, you have a clear signal to push back on urgent, unplanned work. Not because it’s unimportant, but because adding more work will delay everything else already in motion.
To improve flow load:
- Limit WIP: Set clear caps on how much work can be in progress at once.
- Track work item age: Older tasks often signal overload or hidden blockers.
- Set flow thresholds: Define safe limits so your teams know when to pause new work and focus on finishing.
5. Flow distribution: How balanced your workload is

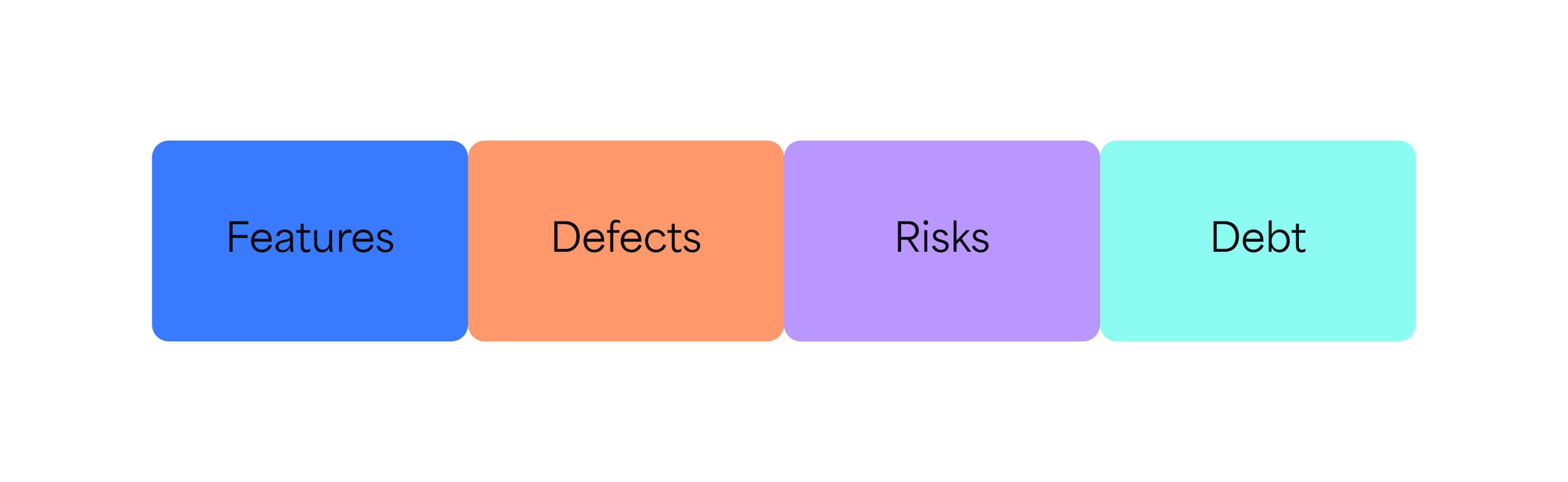

Flow distribution shows how your work is split across four categories: features, defects, risks (security and compliance), and technical debt.
Flow distribution = (items in category ÷ total items) × 100
Example: You completed 200 items this quarter:
- 120 features
- 40 defects
- 25 debt
- 15 risks
Your flow distribution for the features category will be (120 ÷ 200) × 100 = 60%.
It adds important context to your DORA metrics, helping you understand not just how fast you deliver, but what you’re actually delivering. And balance matters more than volume.
If most of your capacity goes to features, it may look like progress in the short term. Over time, though, neglected debt and risks build up. Systems get harder to change, incidents increase, and delivery slows. Strong teams use flow distribution to protect long-term stability while still shipping new value.
The mix varies by stage:
- A mature product might lean toward stability — roughly 50 to 60% features, with the rest spread across defects, debt, and risks.
- A new market entry may skew heavily toward features early on, then rebalance as the product scales and complexity grows.
To improve flow distribution:
- Define work categories clearly: Make sure your teams classify work consistently across tools.
- Reserve capacity: Set aside bandwidth for debt and risk work so it doesn’t get deprioritized.
- Monitor trends: Don't focus on just snapshots. Watch shifts over time to catch imbalances early.

Benefits of tracking flow metrics
Flow metrics give you a clear, system-level view of how work moves across your organization. Instead of relying on scattered updates, you get consistent signals that help you improve delivery, align with business goals, and make better decisions at scale.
Here’s how they help:
- Create a single source of truth: See how work moves across teams. No more piecing together updates from Jira, Git, and meetings.
- Run sharper monthly business reviews (MBRs): Walk in with clear signals instead of anecdotes. Example: “Flow time increased 18% due to QA queue growth. Work is waiting for six days before testing. We’re proposing automation to remove that delay.”
- Justify investments with data: Tie delivery issues to outcomes. Whether it’s headcount, tooling, or process changes, you can show the “why” behind the ask.
- Reduce reporting overhead: Automatically pull data from Jira and Git. No manual reports. No stale dashboards.
- Align work with business priorities: Understand whether your teams are spending time on features, defects, risks, or debt, and adjust accordingly.
How to use flow metrics in practice

Flow metrics start to matter when you use them to make decisions. They help you move from “what happened” to “what needs to change,” especially when delivery starts to feel unpredictable.

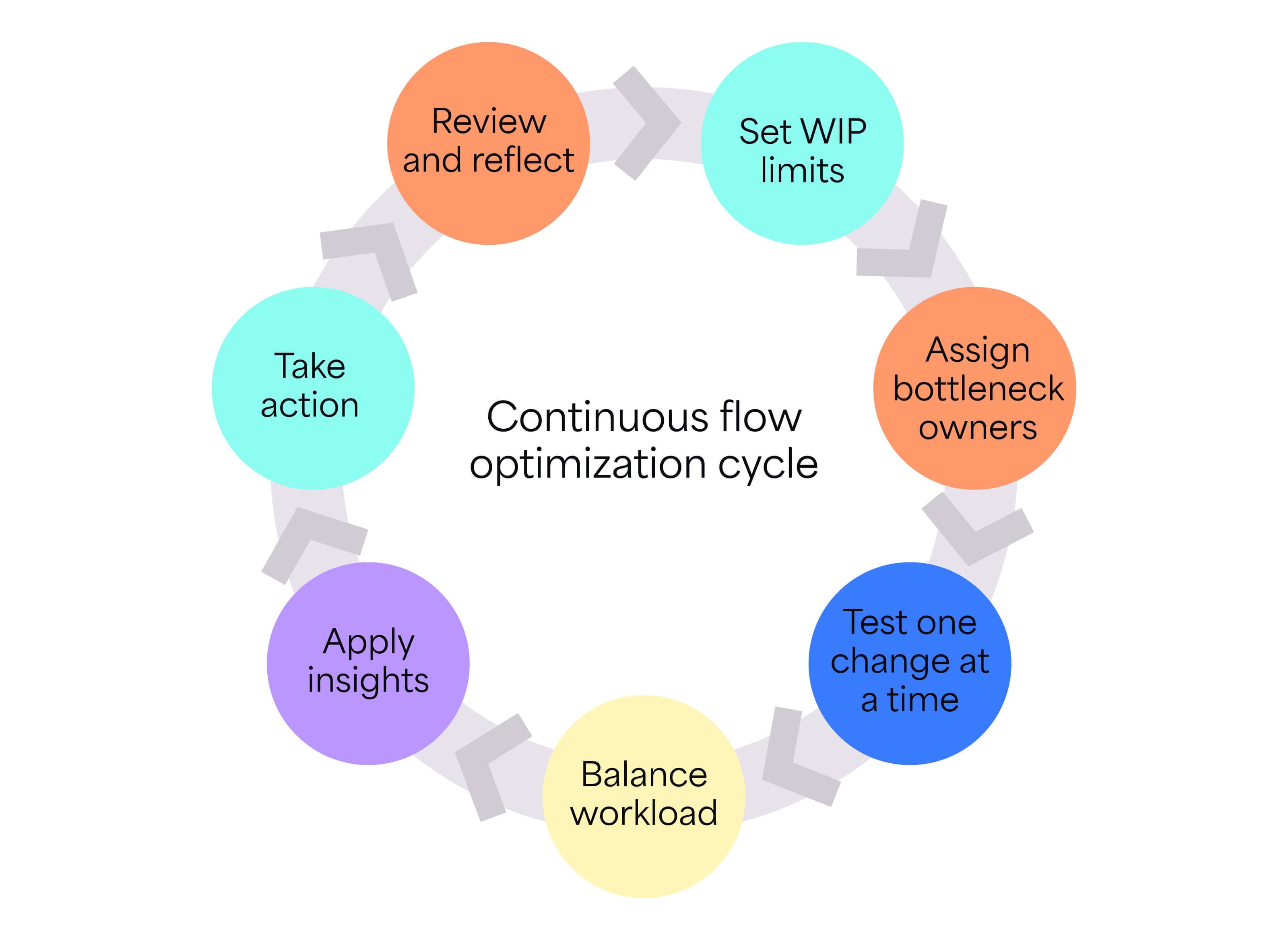

Here's a simple way to put them to work:
- Review flow metrics in every retrospective: Identify where work waited the longest and agree on one fix for the next sprint.
- Set WIP limits based on flow load: Pause new work when limits are hit to clear existing queues first.
- Assign an owner to each bottleneck: Make one team or role responsible for reducing delays in that stage.
- Track one change at a time: Measure the impact on flow time and efficiency before moving to the next fix.
So instead of guessing, you can act — add parallel environments, move testing earlier in the process, or rebalance responsibilities across teams. This is where flow metrics become active tools. You’re not reacting to delays. You’re removing the cause.
The same applies to workload balance.
If your flow distribution shows 70% of effort going to features, while defects and debt are rising, that’s a signal to rebalance before stability takes a hit. When paired with AI metrics and automation insights, you can make these adjustments faster and with more confidence.
To start using flow metrics in your day-to-day:
- Bring them into retrospectives: Review flow time and efficiency to spot where work slowed down.
- Use them in planning: Set WIP limits and capacity based on real flow data.
- Review trends in leadership meetings: Focus on patterns instead of one-off spikes.
- Tie metrics to actions: Every signal should lead to a decision or experiment.
Flow metrics vs. DORA metrics: Which one should you use?
Flow metrics and DORA metrics answer different (but connected) questions.
DORA focuses on delivery performance. How often you deploy, how fast changes move, and how stable your releases are. Flow metrics focus on value delivery — what kind of work is moving, how long it takes, and where it gets stuck.
One looks at system performance. The other looks at the work flowing through it.
Think of it as two layers:
- DORA tells you how well your delivery engine runs.
- Flow tells you what the engine is working on and whether that work aligns with business goals.
- If deployments slow down, DORA flags it. Flow helps explain why.
Example: DORA shows a drop in deployment frequency. Flow distribution reveals 40% of capacity shifted to defects. Now you have context and a direction.
The strongest teams use both together.
DORA informs how to improve engineering practices. Flow metrics guide what to prioritize and where to remove friction. With data flowing from tools like Jira (often powered by Jira automation) and Git systems, you get a connected view, from code to customer impact.
Area | DORA metrics | Flow metrics |
|---|---|---|
Focus | Delivery performance | Value delivery |
Key question | How well are we delivering? | What are we delivering, and how is it flowing? |
Scope | Technical outcomes (deployments, failures) | Work movement (time, load, distribution) |
Insight type | Lagging indicators | Leading + diagnostic signals |
Best use | Improve DevOps best practices | Optimize flow and align with business goals |
Drive change through actionable insights with Appfire Flow
Turning insight into action is where most teams get stuck. Appfire Flow helps you connect the dots across Jira and Git, so flow metrics aren’t trapped in dashboards. You see where work slows, why it slows, and what to fix across teams, tools, and workflows.
Lightspeed used Appfire Flow to move from visibility to impact, cutting cycle time by 35%, reducing pull request merge time by 14 hours, and improving onboarding, planning, and retros with real data.
Book a free demo to see how you can turn flow metrics into decisions your teams and your stakeholders can trust.
Flow metrics FAQ
How do I start measuring flow without making my developers feel micromanaged?
Keep the focus on the system instead of the individual. Flow metrics highlight where work slows down — queues, handoffs, unclear steps. They’re meant to fix broken processes, not evaluate people. Frame them as a way to make work easier rather than tracking effort.
What is a good flow efficiency percentage for a mature team?
Use the flow efficiency formula: active time/total flow time. In complex enterprise setups, 30 to 40% is a healthy range. A hundred percent isn’t realistic, and some wait time is natural.
How do flow metrics help with predictable delivery in 2025?
They give you a baseline you can trust. Historical flow velocity and flow time show how work actually moves, so you can forecast timelines with more confidence. That means fewer surprises and smoother conversations with the business.
Can I track flow metrics if my teams use different Jira configurations?
Yes, but you need a common lens. Map different workflows and statuses to a shared value stream. Once everything aligns to the same stages, you get consistent, comparable data across teams, even if their Jira setups differ.
